How Long Does a Bathroom Remodel Take on Long Island?
← Back to Home
Alec's Construction · Long Island, NY · May 2026

One of the top questions from Long Island homeowners considering a bathroom remodel is how long they'll be without a functioning bathroom. The honest answer is longer than you expect, but there are ways to minimize disruption. Here's a realistic breakdown of the full timeline from start to finish in Nassau and Suffolk County.

Pre-Construction Phase (2–8 Weeks Before Demo)

Design and selection (1–3 weeks): Before a contractor can order anything, you need to select tile, fixtures, vanity, and all finishes. Many Long Island homeowners underestimate this stage. Visiting tile showrooms in Melville or Hicksville, comparing vanities online, and making coordinated material decisions takes time. Rushing this phase leads to regrets.

Permit application (1–4 weeks): In Nassau County, permit turnaround times currently run 2–4 weeks for standard bathroom projects. Suffolk County varies by town — Huntington tends to be thorough and can take 3–5 weeks. Brookhaven is generally faster. Your contractor submits for the permit; you cannot start work until it's approved.

Material lead times (1–6 weeks): Special-order tile, custom vanities, and imported fixtures have lead times. A vanity from a domestic manufacturer might be 1–2 weeks. Imported tile ordered through a Melville showroom might be 4–6 weeks. Experienced Long Island contractors order materials early enough that they arrive before demo starts.

Plan ahead: From the day you sign a contract to the day demo starts, expect 4–8 weeks for a properly managed project in Nassau or Suffolk County. This is normal and unavoidable when permits and special-order materials are involved.

Construction Phase (1–3 Weeks)

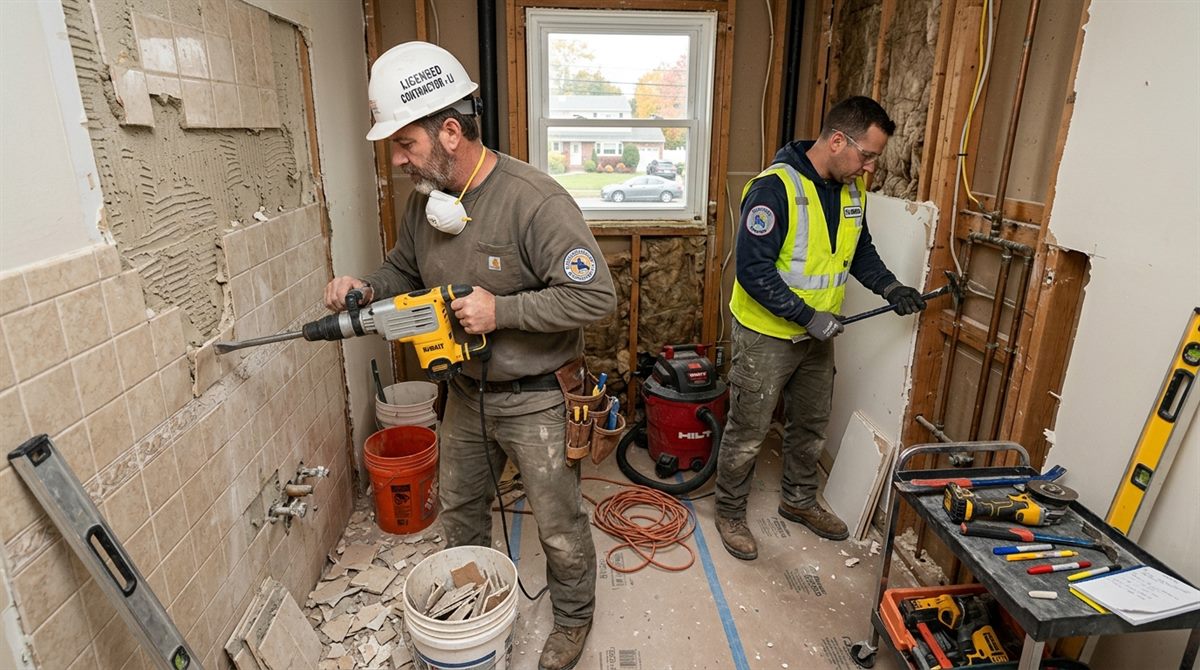

Demo (1–2 days): Removing old tile, fixtures, and wall materials goes quickly. Demo generates significant debris — a responsible Long Island contractor hauls this out daily. In older homes, demo sometimes reveals surprises: rotted subfloor, outdated cast iron pipes, or insufficient waterproofing.

Rough plumbing and electrical (1–3 days): If pipes or electrical need relocation, this happens after demo and before any wall work. This is when the rough-in inspection occurs in jurisdictions that require it.

Waterproofing and cement board (1–2 days): Critical stage for shower walls and floors. Proper waterproofing membrane application requires dry time before tile can go up. Never let a contractor skip or rush this stage.

Tile work (3–6 days): This is the longest single phase. Floor-to-ceiling tile in a shower, large-format floor tile, and any decorative work adds days. Grout curing requires 24–72 hours before the shower can be used.

Vanity, fixtures, and finish work (1–2 days): Installing the vanity, toilet, shower fixtures, glass door, mirrors, and accessories. The final inspection is scheduled during or after this phase.

Final inspection and punch list (1–3 days): The building department inspection, addressing any final items, and cleaning up. Most Long Island inspections are scheduled within a few days of request.

Total construction time for a standard full bath remodel: 10–18 business days once demo begins. A complex master bath with extensive tile work and multiple permit inspections can run 3–4 weeks of active construction.

Alec's Construction provides detailed project schedules before work begins so Long Island homeowners know exactly when to expect each phase and how to plan around bathroom access.
